Big projects take teamwork, and every project manager knows collaboration is the fuel that gets projects across the finish line faster.
If you want to build a gantt chart your whole team can work on, you’ve come to the right place! We’ve got 3 different options for you, depending on the time you can afford to spend and the gantt chart features you’re looking for.
This step-by-step tutorial guides you through how to build a basic gantt chart in Google Sheets from the ground up.

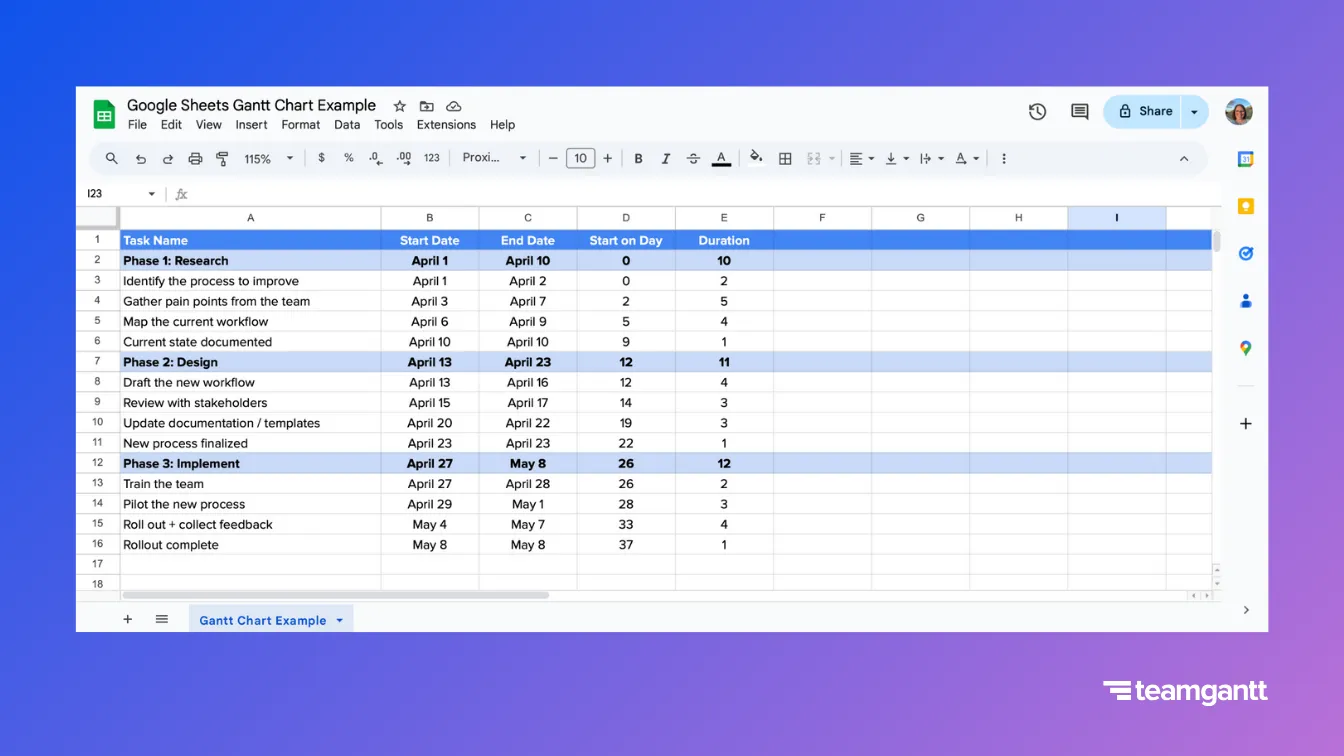

Create columns for Task Name, Start Date, End Date, Start on Day, and Duration. Complete the first 3 columns with the basic details for your project tasks and milestones.
Format these columns as follows:
Use an automated formula to determine the interval between the first task’s Start Date and each subsequent task in your project.

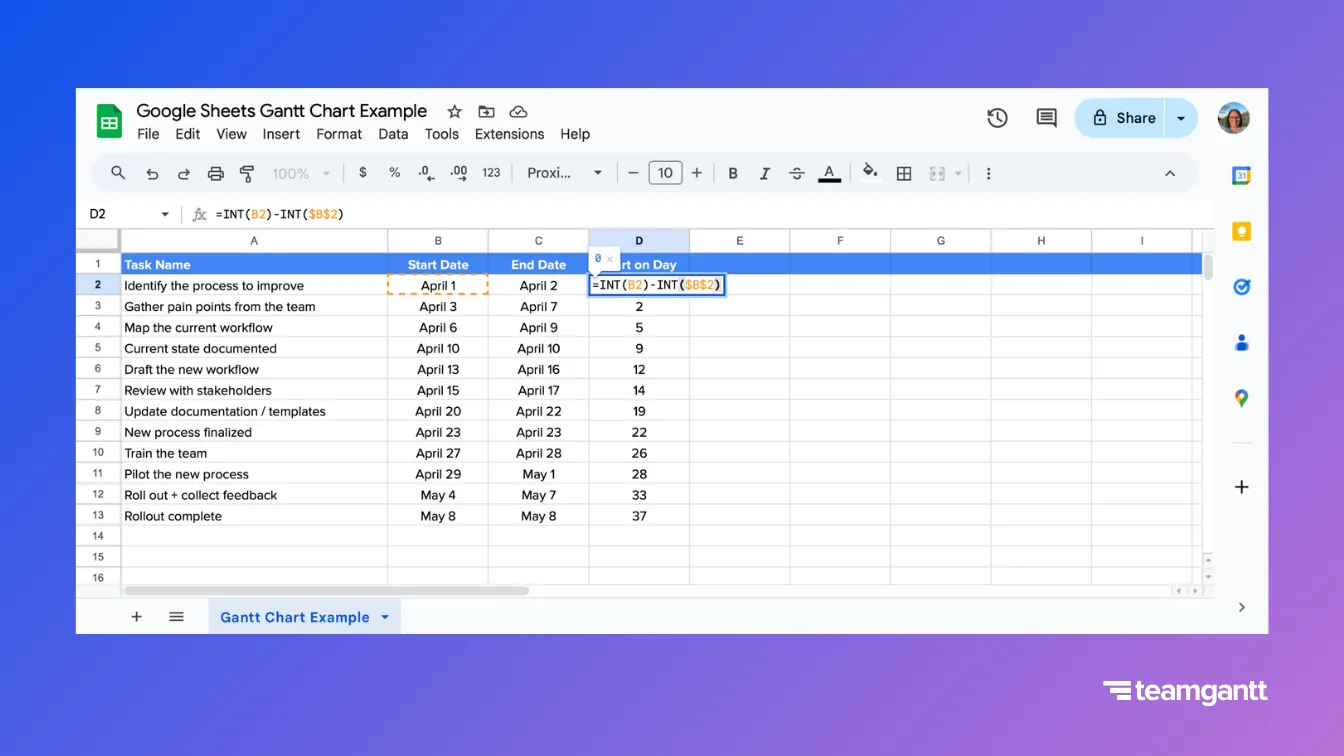

In our gantt chart example, we entered the following formula into the Start on Day cell for our first task: =int(B2)-int($B$2).
Tip: If you started in different cells in your worksheet, be sure to adjust each formula accordingly.
Google Sheets will prompt you to autofill the rest of the Start on Day column. Click the green checkmark icon to apply this formula to the remaining cells in column D.
Next, add a formula that subtracts the start date from the end date in the Duration column. That way your Google Sheets worksheet will automatically calculate the length of each task in your gantt chart.

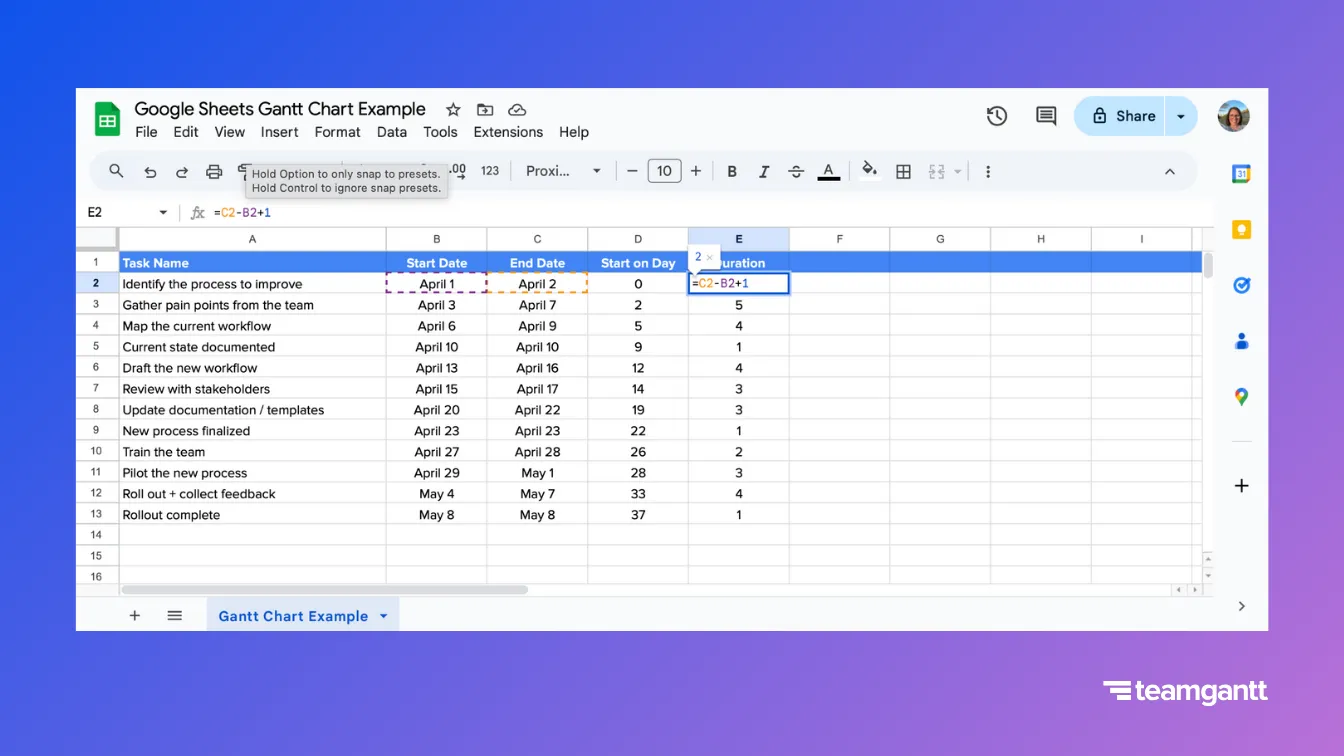

In our Google Sheets gantt chart, we entered =C2-B2 into the Duration field for our first task.
Tip: If you started in different cells in your worksheet, be sure to adjust each formula accordingly.
Google Sheets will prompt you to autofill the rest of the Duration column. Click the green checkmark icon to apply this formula to the remaining cells in column E.

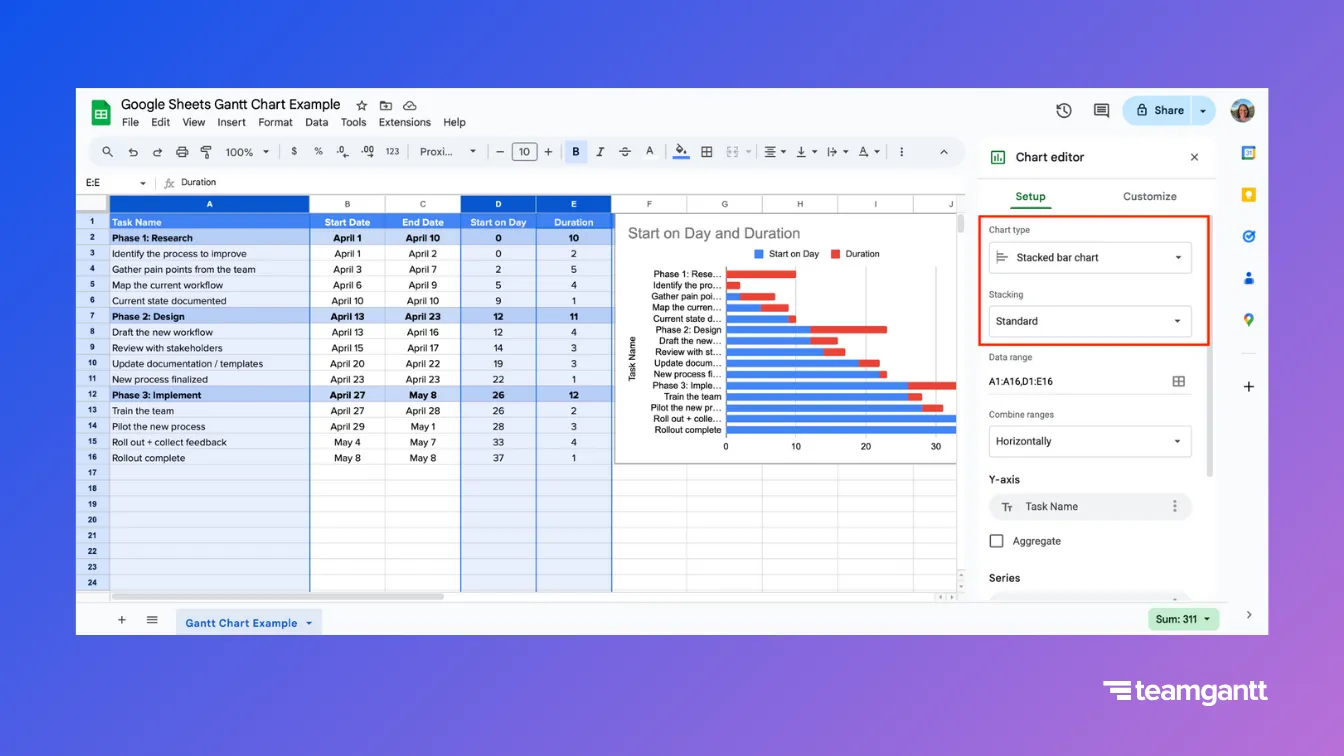

Highlight all the completed cells in columns A, D, and E to select the data you’ll use to populate your gantt chart.
Click Insert >Chart, and choose Stacked bar chart from the Bar section to add a chart to your Google Sheets worksheet.

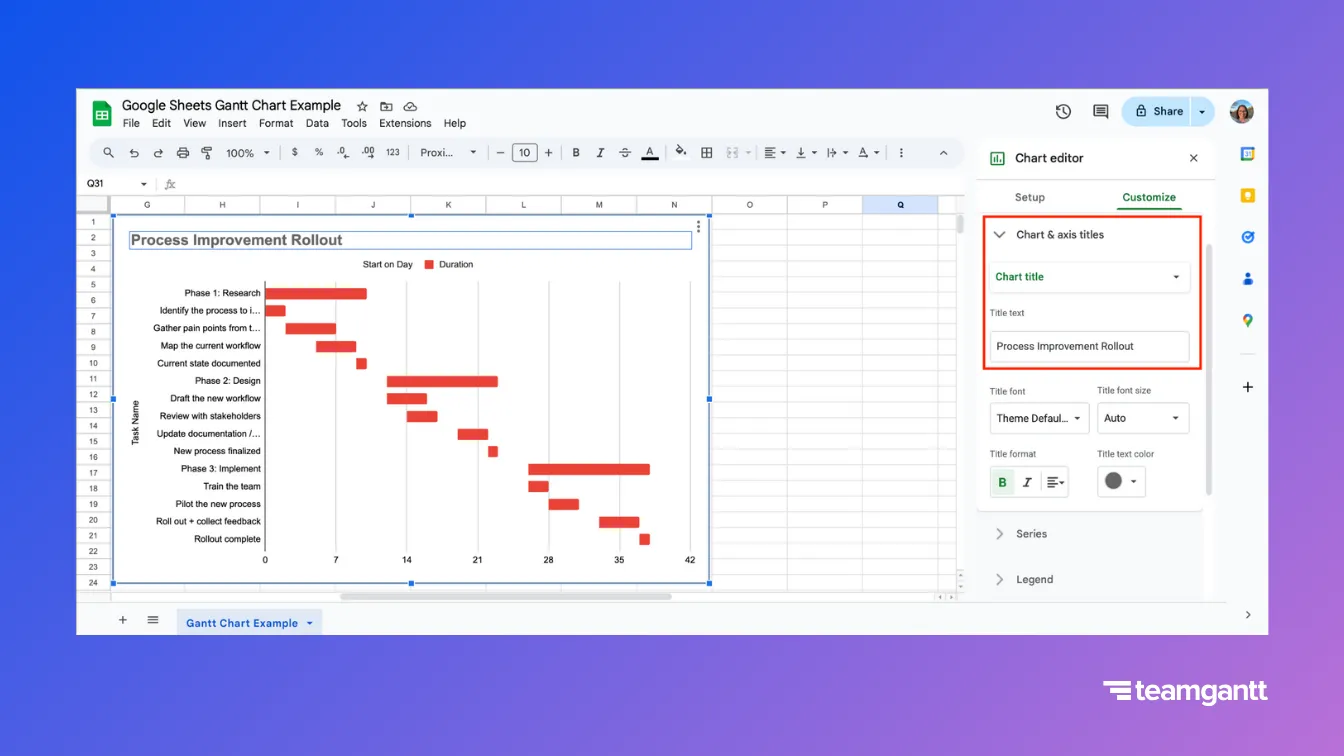

Double-click the chart title text box to select the full title, and enter the name of your project to replace the placeholder text.
Tip: You can also update the chart title in the Chart Editor settings under Chart & Axis Titles.
Next, format the stacked bar chart in your Google Sheets worksheet to look like a gantt chart by removing the fill color from the first portion of each bar.

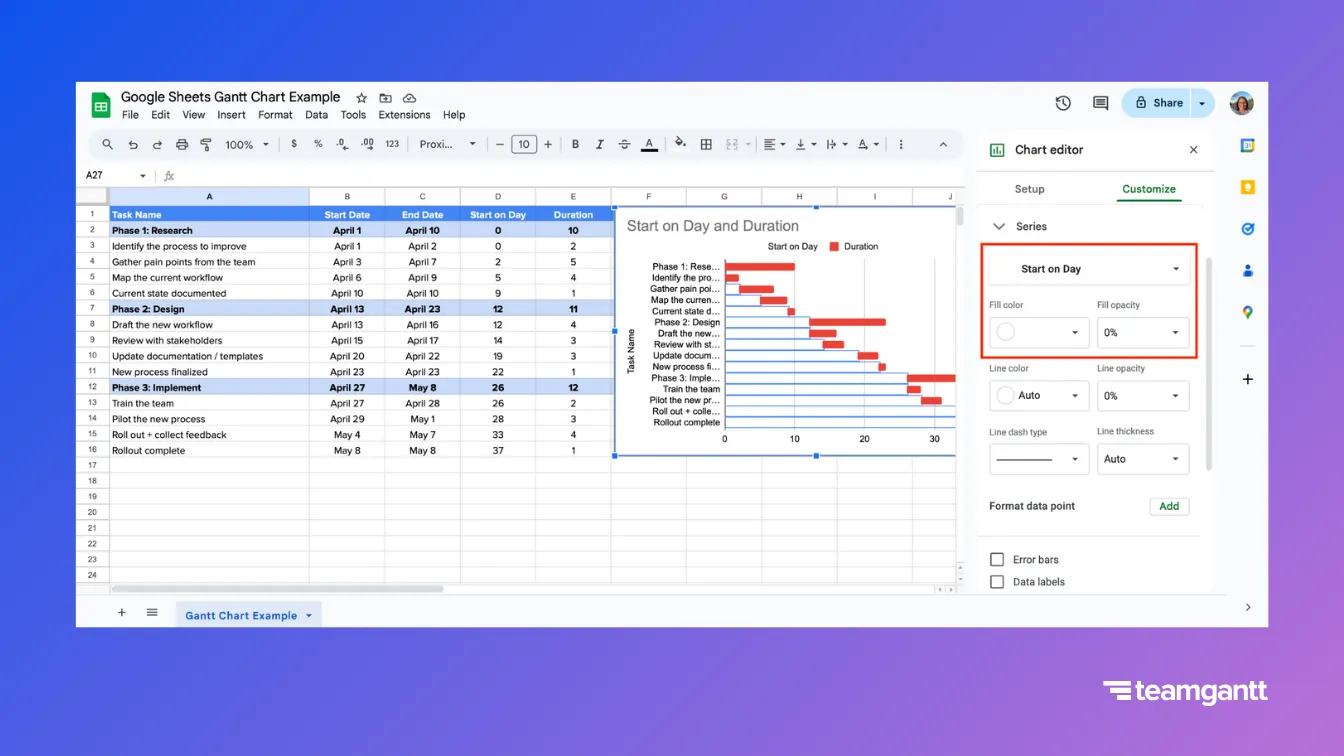

Click on the Start on Day portion of any bar in your chart to select the entire data series. In our example, this data series is represented by blue bars.
Then click the Fill color menu in your Series settings, and select either white or No fill to remove the blue bars that precede your task start dates.

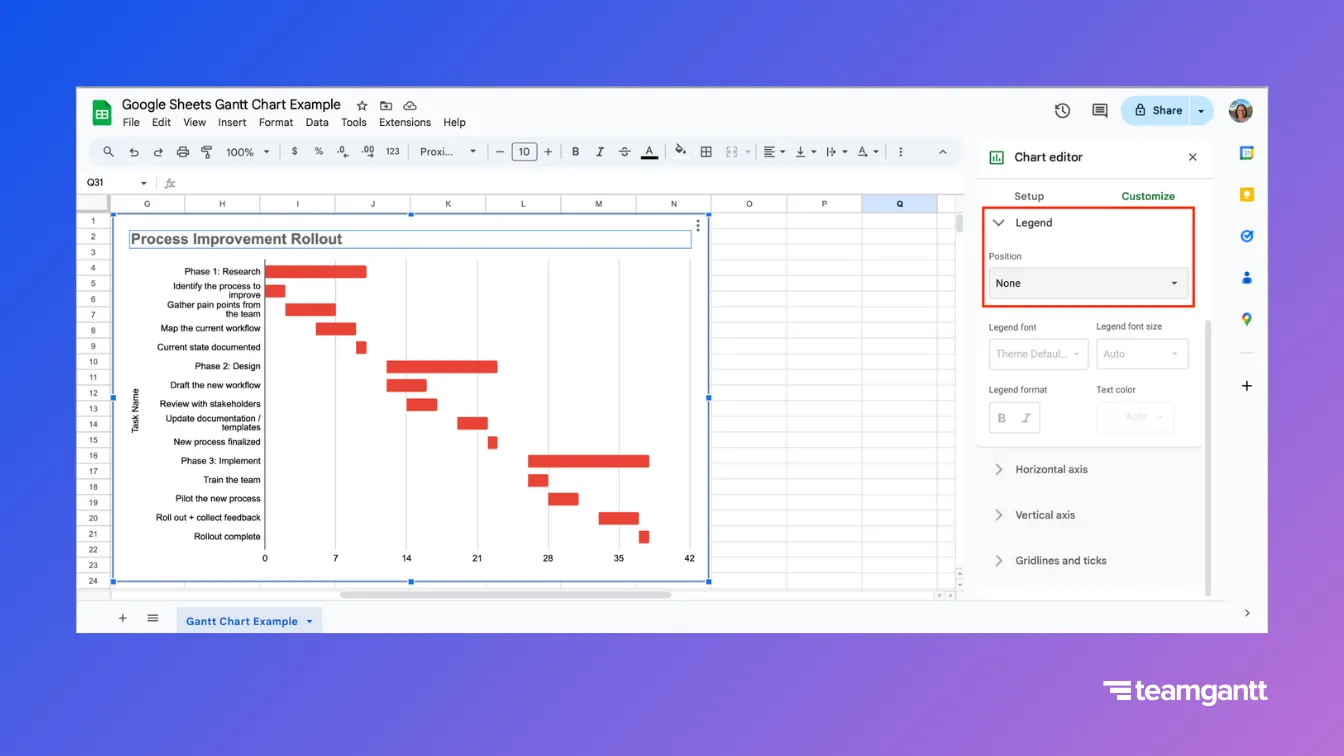

Open the Legend menu from the Customize tab on your Chart Editor settings, and choose None from the Position menu.
Next, adjust the labels on each axis of your Google Sheets gantt chart to keep it clean and easy-to-read.
Open the Chart & axis titles menu from the Customize tab on your Chart Editor settings.

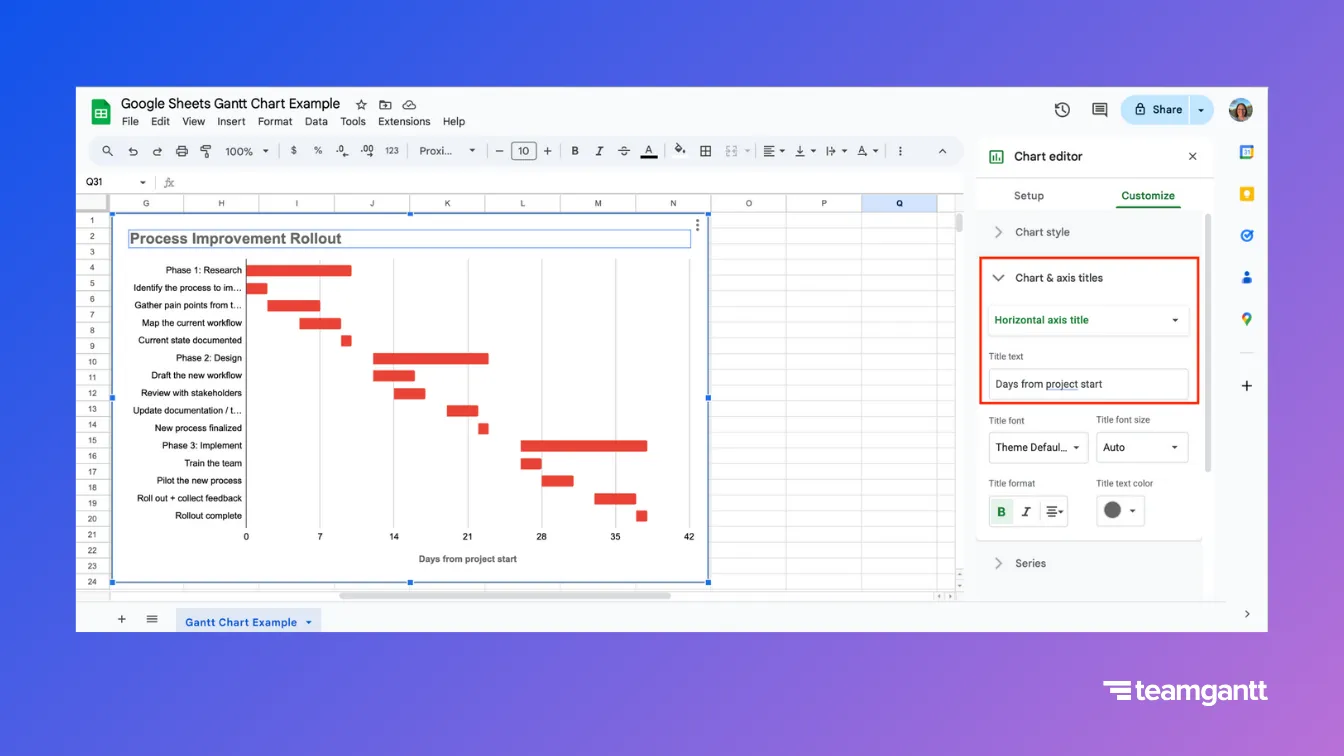

Select Horizontal axis title, and enter Day of the Month in the Title text field.
Then select Vertical axis title, and delete Task Name to blank out the Title text field.

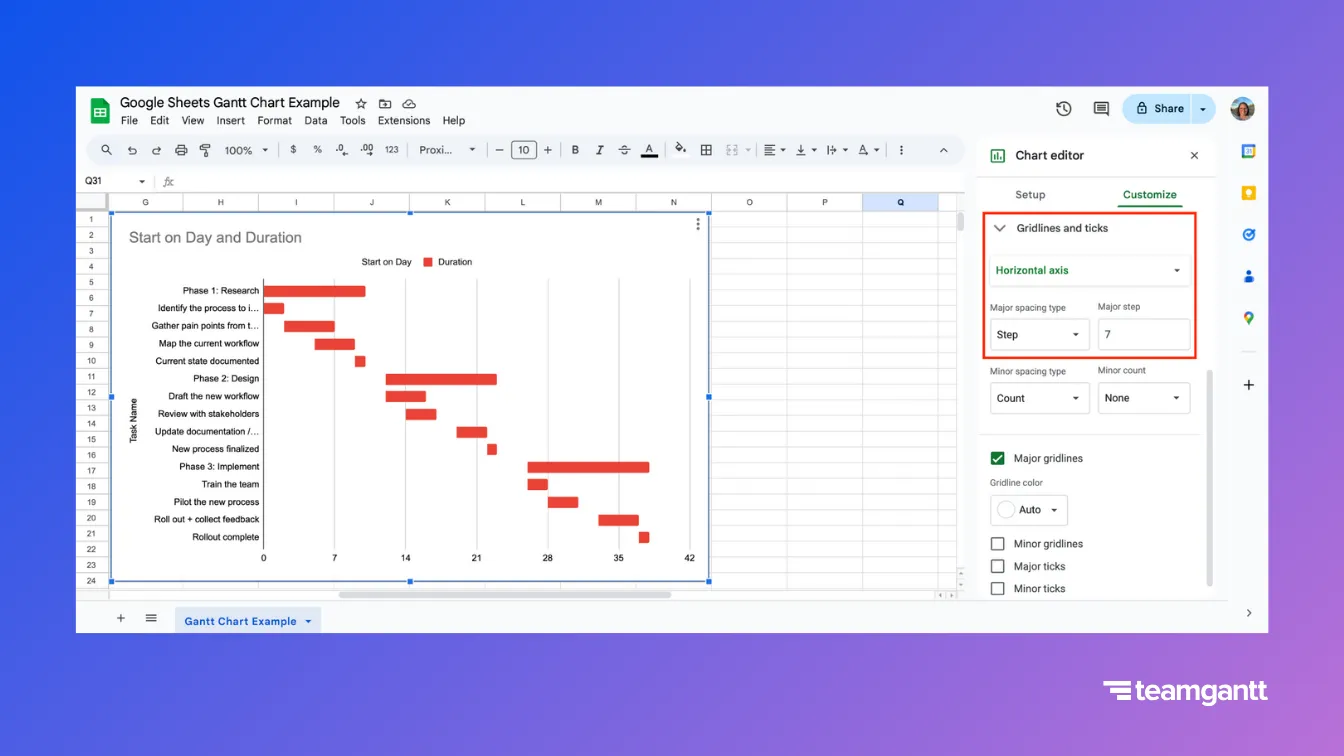

Right now, our gantt chart displays the timeline in 20-day intervals. Let’s change that to 7 days, so we can see project tasks laid out in a weekly view.
Open the Gridlines and ticks menu from the Customize tab on your Chart Editor settings, and enter 7 in the Major step field.

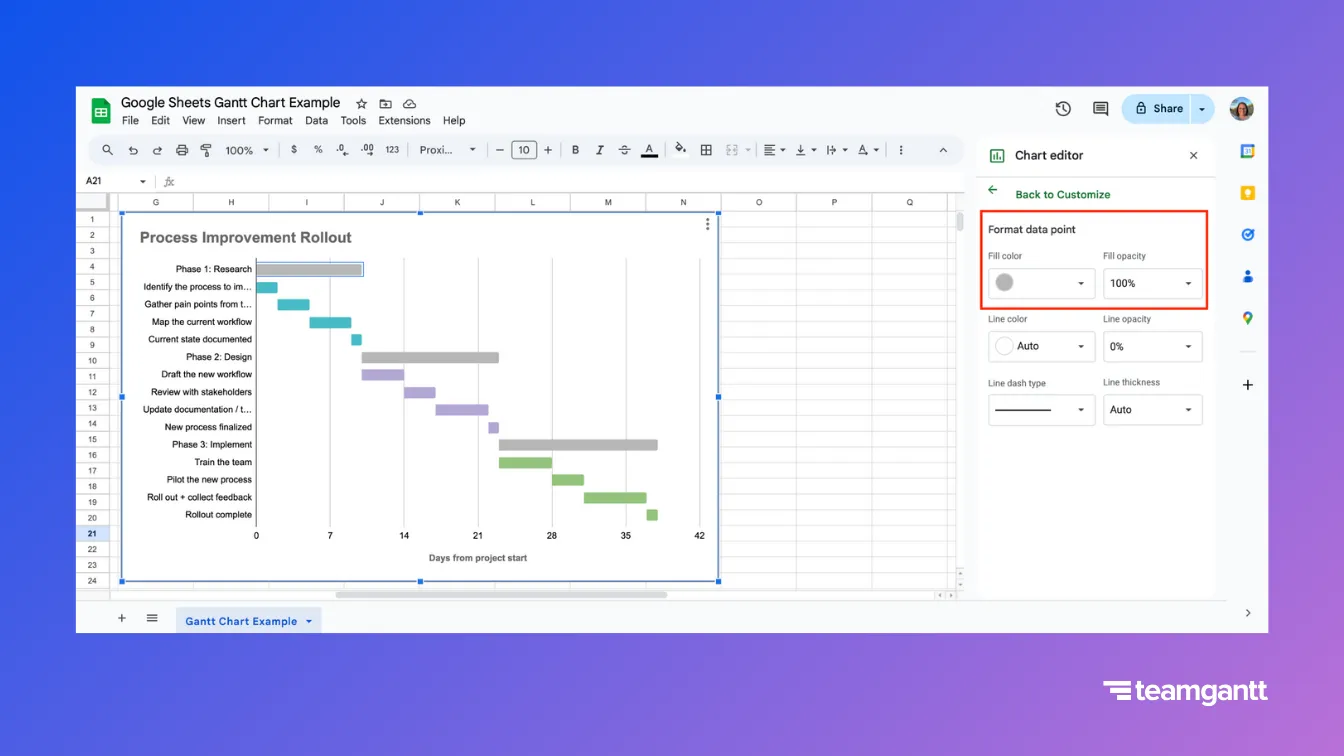

Finally, give your Google Sheets gantt chart a custom look by applying your favorite colors to the taskbars.
Click on a single taskbar twice. Don’t double-click it—click it once to highlight all the bars in that color, then click it again to highlight a single bar.
Click the Fill color menu in the settings, and choose the color you want from the palette options.
Repeat this process to change the colors of the rest of the taskbars in your newly made Google Sheets gantt chart.

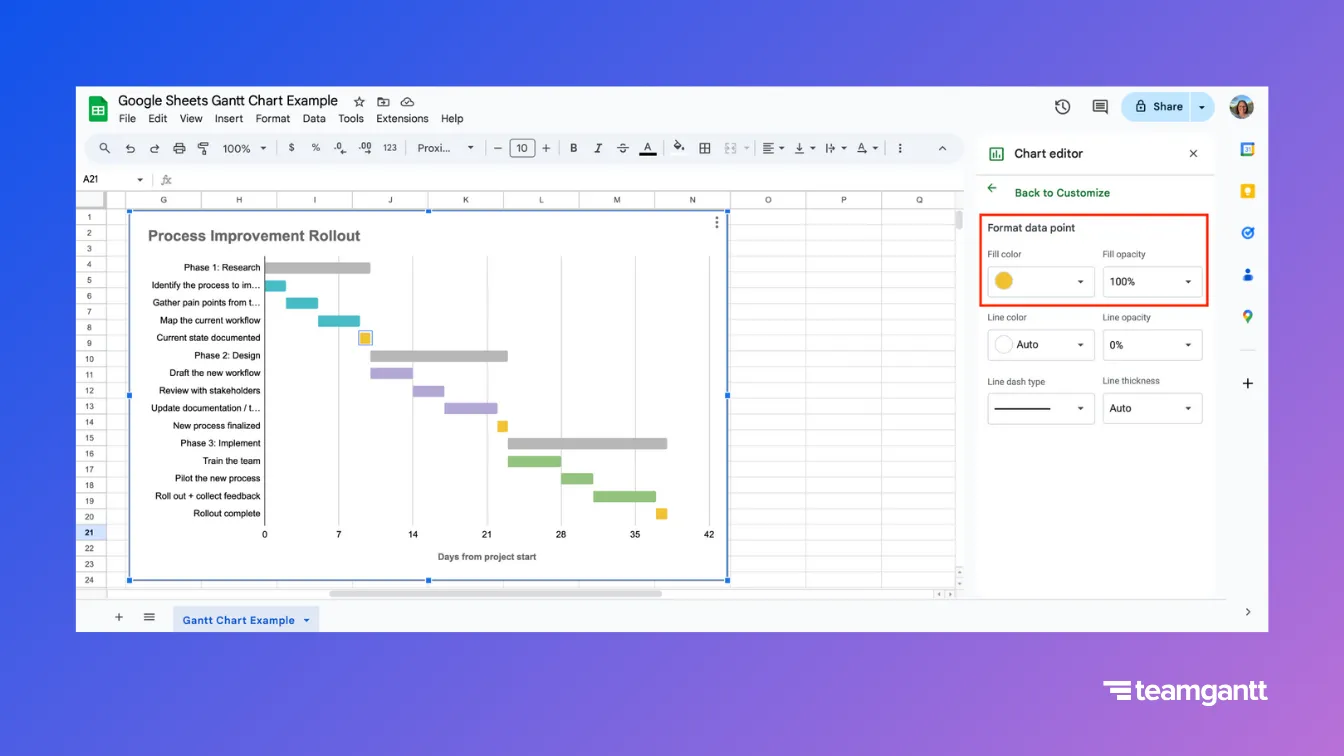

Tip: Color milestones yellow or gold so they stand out easily from other tasks.
Congratulations! You’ve created your very own gantt chart in Google Sheets. Feel free to customize it even more to fit your project needs.
Building a Google Sheets gantt chart from scratch was probably more steps than you anticipated—especially if you have to do that every time you make a timeline for a project. That’s why we created an automated template to help you save time and effort.
Download our dynamic Google Sheets gantt chart template to get started. We’ve done all the heavy lifting for you.
Once you’ve downloaded TeamGantt’s automated Google Sheets gantt chart template, give yourself a high-five, then put your own fresh spin on it.
Tip: To edit the template, you'll need to save a copy to your own Google Drive first. Simply click File >Make a Copy, and you're ready to go!
Follow these simple steps to adapt our free Google Sheets template to your project needs.
TeamGantt’s Google Sheets gantt chart template gives you 3 choices for building your own project timeline. You can find each gantt chart option on the tabs at the bottom of the worksheet.
Giving each gantt chart a project-specific name helps minimize confusion, especially if your team has multiple projects to juggle. Here’s how to personalize your Google Sheets gantt chart:
We’ve preloaded this Google Sheets gantt chart template with 4 sample projects that you can customize to fit your company’s needs. Simply swap out the placeholder data with your own project tasks to make it your own!
Next, you’ll want to establish a timeline for each task in your project.
A project plan works best when it acts as a living document everyone can use to log up-to-the-minute project updates.
We applied our favorite shade of blue to the progress indicators in this gantt chart template, but feel free to switch up the palette to match your own brand colors.

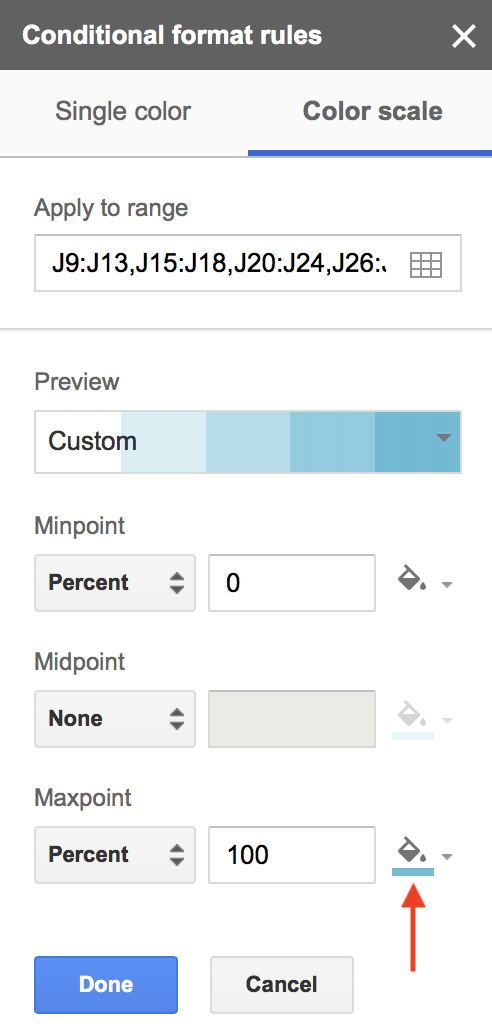

To change the color scale in the Percent Complete column:
To change the progress bar color scheme:
Sharing is caring, so why keep your Google Sheets gantt chart all to yourself? Follow these easy steps to spread the project joy.
Want to let team members or stakeholders in on your beautiful new project plan? Here’s how.
Got a big presentation coming up? Show off your project progress by importing your gantt chart into Google Slides.
To import your Google Sheets gantt chart into Google Slides:
Google Sheets is a great option for sharing simple projects that won’t throw you any curveballs. But we all know change is a constant—especially when people and projects are concerned.
Lucky for you, TeamGantt’s got you covered! Give our gantt chart software a free try, and roll with the project punches in real time. Here are just a few of the features you’ll have at your fingertips.
Need to rearrange your whole plan? No problem! Change start and end dates and adjust timelines, all in a matter of seconds. Create dependencies to ensure tasks stay in the right order with every move you make.
TeamGantt comes jam-packed with tools for keeping your team and stakeholders in the loop. Streamline conversations, store documents, and share key updates so no one’s left in the dark about a project.
Crush deadlines without busting your budget—or your team’s spirit. With TeamGantt’s forecasting features, you can check team availability before assigning tasks so everyone has just the right balance of work.
You don’t have to wear a cape to be a superhero. You simply have to give your team the tools they need to succeed.
With TeamGantt’s collaborative project management software, you can boost your project power without breaking a sweat or spending hours on the details.
Try TeamGantt for free today!
Unfortunately, Google doesn’t come with a built-in gantt chart template. You’ll need to create a gantt chart manually in Google Sheets, then save it as a template for future project use.
You can save any Google Sheets file you make as a template. Simply follow these steps to build a gantt chart of your own in Google Sheets. Then click File > Save as template to create a Google Sheets gantt chart template you can use again and again to schedule project timelines.
To format your gantt chart by week in Google Sheets, open the Gridlines and ticks menu from the Customize tab on your Chart Editor settings, and enter 7 in the Major step field.
To format your gantt chart by month in Google Sheets, open the Gridlines and ticks menu from the Customize tab on your Chart Editor settings, and enter 30 in the Major step field.
It won’t be a perfect monthly picture since some months have more or less days, but it should provide a decent visual approximation for your Google Sheets gantt chart.
Start by downloading our free Google Sheets gantt chart template, which has progress bars built-in. Then all you have to do is update progress in the Percent Complete column, and Google Sheets will adjust the taskbar on the gantt chart to reflect the current status.
